An EOT crane down for four hours doesn't just cost four hours. It stalls the line waiting on material, the fabrication bay waiting on the next plate, the truck idling at the gate. This guide covers what actually causes EOT crane downtime, the standards behind inspection intervals, and where fixed-interval maintenance falls short.

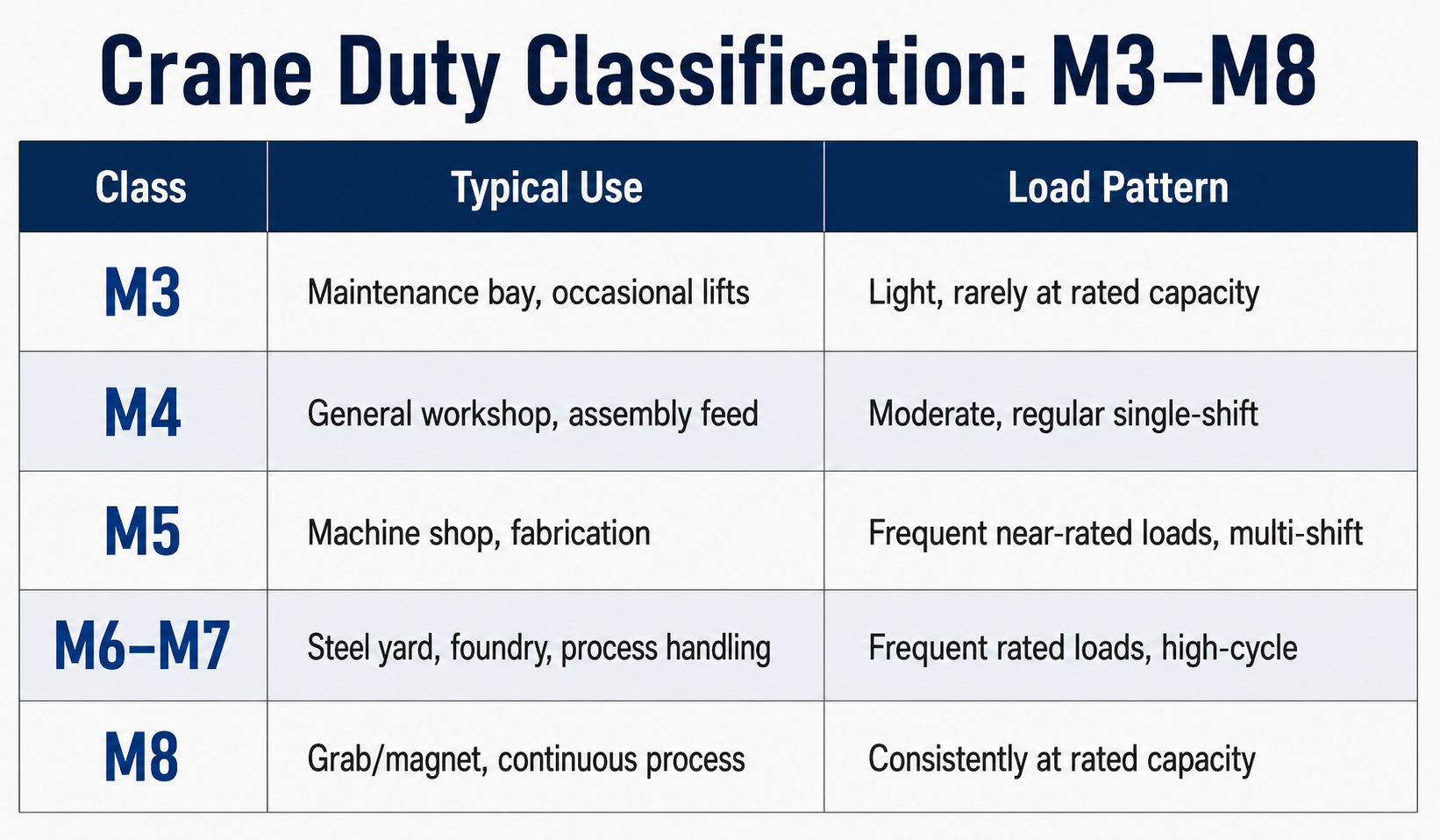

Before any interval means anything, you need to know the crane's actual duty class. IS 3177 (aligned with FEM/ISO groupings) rates cranes from light, occasional use to continuous, near-capacity use, based on load spectrum and expected operating hours.

Two plants running the same tonnage crane can see very different failure rates if one runs M5-rated equipment at M7 duty. Copying OEM intervals written for a lighter duty class than your actual usage is the most common reason a "properly maintained" crane still breaks down early. Check the nameplate and design duty before setting anything below.
Planned downtime is scheduled PM, statutory inspection, and load testing. Unplanned downtime is everything else, and it's what actually hurts, since it hits mid-shift with no buffer.
Two numbers worth tracking:
Most plants log "the crane broke down again" instead of fault type, repair time, and part replaced. Six months of the latter tells you more than any checklist. Indirect costs, idle labor, missed dispatch, and penalty clauses usually exceed the repair bill itself.
Wheel and rail wear. Slight misalignment accelerates flange wear on one side, then rail wear, then skewing during travel. Measure flange thickness against the OEM discard limit (commonly around 50% of original thickness confirm against your wheel drawing), don't eyeball it.
Wire rope fatigue. Rope degrades through broken wires per lay and diameter reduction, not sudden failure. IS 3177 sets discard criteria on both; roughly 7% diameter loss from nominal is a common trigger, but this varies by rope construction, so confirm against the current standard.
Gearbox oil degradation. Heat cycling breaks down oil viscosity quietly. Sample for viscosity drift, water content, and particle count rather than relying on a fixed change interval alone.
Brake torque drift. Hoist brakes are typically specified around 150% of rated load torque (verify against your brake's design data). A dragging brake heats the motor and wears linings faster; an under-torqued brake is a direct safety risk. Check with a torque wrench, not by feel.
Busbar and collector shoe wear. Uneven shoe wear causes arcing, which pits the busbar and shows up as intermittent power loss. Check for carbon tracking during weekly inspection.
Limit switch drift. Vibration and cycling shift calibration over time, causing nuisance stops (too early) or safety risk (too late). Recheck overtravel margin quarterly, not just at commissioning.
Festoon cable and contactor wear. Cable jackets crack at flex points before conductors fail. Contactors pit faster on cranes run with heavy inching; a megger reading trending down from baseline, even if still above the typical 1 MΩ minimum, flags a developing problem.
Girder camber loss and bearing failure. Repeated overload cycles flatten girder camber gradually, checked with a level against design reference points, not by eye. Ungreased or misaligned end truck bearings usually announce themselves as noise or vibration before they seize.
Process failures. Operators exceeding rated capacity, skipped daily checks, and poor rail housekeeping cause a large share of what gets logged as "mechanical" failure. No schedule fixes a routinely overloaded crane.
Tighten weekly items to twice-weekly and monthly to fortnightly for M6+ duty.
Fixed intervals miss failures that develop faster or slower than the calendar assumes, and that gap is where a lot of unplanned EOT crane downtime actually originates.
Even a monthly handheld vibration reading, logged against the same bearing over time, beats a purely visual check.
For M5+ duty cranes: brake shoes/linings, hoist and travel limit switches, contactors matched to the panel, a spare wire rope length, collector shoes, pre-cut festoon cable. Imported OEM electricals can have long lead times in India; confirm local availability before you need a part urgently.
These patterns show up repeatedly in plants with recurring breakdowns:
Depends on crane count and duty class, in-house access to a megger, thermal camera, and calibrated torque wrench, and how critical the crane is to the line. If a stoppage halts the whole line, a data-driven AMC usually costs less than even one unplanned multi-hour breakdown per quarter.
Macroverse, founded in Chennai in 2017 by Sudharshan M and Prasandh S, runs AMC and preventive maintenance for EOT, gantry, and jib cranes across Chennai, Tamil Nadu, and major industrial sectors in India, covering both their own cranes and other manufacturers' equipment. Their AMC includes IoT-enabled monitoring to predict failures before they cause a breakdown, along with digital inspection records instead of paper logs. Where a plant lacks the instrumentation or trained technicians for condition-based checks, an external AMC usually makes more sense than stretching an in-house electrician beyond their scope.
